New homes - Construction update
Residential Phase - Phase 2B (delivered by Barratt London)
The new sales and marketing suite for The Lanes development on Plots X, Y & Z has now launched. Feel free to pop in and say hello.

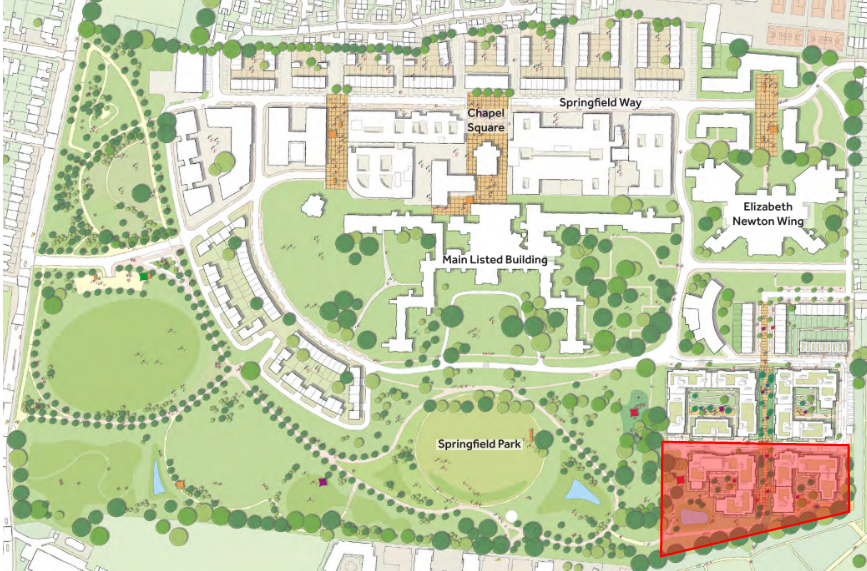

- Upcoming works to Parcel 1 as shaded red on the plan below.
- Demolition to the existing hospital buildings is now complete.
- Enabling works have commenced.
- Targeting to start Piling in October.
- Formation of foundations and groundworks to start following completion of Piling.
- The erection of two tower cranes to assist with the loading out of materials is planned before the end of the year.
Conversion of listed main building to residential - Plot S (delivered by City & Country)
Phase 1 is complete.
Current occupations at the 1840 is 80 in total
Phase 2
Central area comprising of Engineering Tower, Boiler House Units and Dormitory Wing are now complete and residents in occupation. Upcoming activities:
- Central Area – Engineering Block Units fit out in progress
- Orchid Wing - Approximately 50% build complete and occupied, with cores being completed from West to East. Fit out ongoing and progressive build complete with legal completions until November 2025
- External Works – Utilities and landscaping from West to East
Majority of C&C staff to relocate to Building 32, with Lapidge Drive site cabins to be decanted at the end of September (Satellite site facilities to remain in situ).
Phase 3
- Continuation of asbestos removal / soft strip / demo to all blocks
- Ground works / utilities to start
- Structural alterations to start
Next phase of new build residential Plots G, P, Q and F (delivered by London Square)
Sales
- 32 plots have currently been sold which include 12 houses and 20 apartments.
- Occupations to Plot P to commence 25th September 2025.
Block P
- Plot P houses are at various stages of completion.
Block Q
- Scaffold being removed with external services and ground works to follow
- Internal fit out on-going
- Lifts installation in progress
- Plot Q Houses 242 to 249 various stages of 1st fix and closure
- Plot Q Houses 250 – 253 roof finishes in progress with window install to follow
Block G
- Scaffold being removed with external services and ground works to follow
- Internal fit out on-going
- Communal corridor fire stopping in progress
- Window installation in progress
Block F
- Roof and window finishes in process
External CGI from London Square Apartment overlooking Springfield Park
Area of Responsibility Plan
